Risks, uncertainties, opportunities and scenarios

Quick read

A need for disclosure

Companies seek to seize and deliver on opportunities that create long-term value that are aligned to their purpose. But every opportunity and every action (or inaction) has an associated risk. Investing is as much about assessing the risk as the related opportunity. This means that all organisations have a story to tell on these topics to investors, regulators and other stakeholders. But is this story clear, is it connected and does it reflect the organisation's processes?

Connected reporting

This is not the first time that the Lab has specifically looked at the connected areas of risk, uncertainty, opportunity and viability, and in fact many of our projects indirectly cover these areas. We find that there remains a gap between the information users want and the disclosures that organisations provide. This disclosure gap looks set to widen with climate-related uncertainty and an increased demand for enhanced Environmental, Social and Governance (ESG) reporting1.

Time to close the gap

Our discussions with companies have shown that the COVID-19 pandemic has, for many companies, led to a more interconnected approach to navigating risks and opportunities. This new approach is supported by dynamic consideration of uncertainty and longer-term scenario and stress testing. Whilst many companies are beginning to change and improve the way they manage risk, uncertainty and opportunities, this is not always translating into useful disclosure. Investors commented that companies generally communicate opportunities well. However, it is the integration of opportunities and risks and in providing a comprehensive understanding of the risks where company disclosures are not meeting their needs. The focus of this report, therefore, is on the components of information that investors want to see. It provides examples of company disclosure elements that have more closely addressed these needs.

Investor needs

The graphic summarises the key areas identified about which investors seek information relating to risks, uncertainties and opportunities.

This diagram illustrates the key areas investors seek information about regarding risks, uncertainties and opportunities, categorized by: * What information do investors want to understand? * Governance and processes: Who, What, How, When * Context: Connection to macro and micro environment/trends * Importance: Priority, likelihood and impact, viability * Nature * Form: Categorisation (by type, theme or time period) * Linkage: Connection to purpose, strategy, business model, KPIs and longer-term resilience and viability * Approach * Response: Risk appetite, mitigating activities, actions and their evolution * Scenarios and stress testing: Scenarios considered, Robustness, Link to company narrative

Investors seek information relating to risks, uncertainties and opportunities that contributes to their understanding of a company's business model, longer-term strategy, resilience and viability. There is an interrelationship between risks, uncertainties and opportunities and this may change due to internal and external factors. These factors should be identified and considered for appropriate responses to be taken.

Investors want information that builds their understanding of:

  • Governance and processes – Before understanding the nature of the risks, uncertainties and opportunities, investors want to understand how the board and management identifies, monitors and manages these areas and responds in an agile way. This is useful to build a picture of a company (especially when investors might be new to a company) and helps to build confidence in management.
  • Nature – Investors want to build their knowledge of the risks, uncertainties and opportunities through disclosure addressing:
    • Context: what is the company's market position and how does it view macro and micro trends and themes?
    • Importance: how does it fit within the company's plans, how big is it, what is the likelihood and what priority attaches to it?
    • Form: how does the company identify and classify the risks, how do the risks align or connect with the opportunities and the wider company narrative and reporting?
  • Approach - Investors want to understand how management are responding to the risks, uncertainties and opportunities. This requires information about:
    • Linkage: to the wider strategy, business models and metrics that allow the monitoring of risks and opportunities.
    • Response: what is management tangibly doing to mitigate the risk (where relevant) and take forward the opportunity, what have they already done, what will they do in the short, medium and long term and how does this affect wider viability and resilience?
  • Scenarios and stress-testing – Investors want to understand more fully what is on the company's horizon and how this is integrated into the risk and opportunity process. They seek to understand how uncertainty impacts the risks and opportunities and how scenarios provide insight into the range of possible futures. Scenarios are only truly useful if they are company-specific and incorporate information consistent with that provided elsewhere. Investors want to know that such exercises are conducted by the company and whether and how they influence its strategic decisions and, ultimately, its business model.

Challenge

Many companies have evolved their internal processes and conversations around risks, uncertainties and opportunities, and these are becoming more integral to strategy and operations. However, our conversations with investors have highlighted that external reporting does not, at present, adequately report this.

This is, and will continue to be, a challenge for companies, specifically their risk functions. This report highlights examples of where more consistent reporting of risks and related uncertainties and opportunities is beginning to emerge. We challenge companies to reflect this progress in their disclosures and make risk and opportunity reporting a key part of their strategic narrative.

Regulatory context

Recent corporate failures have driven a range of conversations on the regulatory framework. To this end, the Department for Business, Energy and Industrial Strategy (BEIS) recently concluded a consultation on 'Restoring trust in audit and corporate governance'. The reform programme aims to strengthen trust in company reporting, and many of the considerations covered in this report are key to that aim.

This report was written before the finalisation of the reform process and therefore reflects the regulatory environment as at release (see Appendix 1). That being said, our conversations with investors and preparers were far-reaching. Where we received investor and company views on topics related to resilience and other topics mentioned in the BEIS consultation, we have included these within this report.

What information do investors want to understand?

Companies seek to seize and deliver on opportunities that create long-term value that are aligned to their purpose. But every opportunity and every action (or inaction) has an associated risk. Investing is as much about assessing the risk as the related opportunity. Investors have always been interested in the risks that companies face and the impact of those risks on longer-term viability and business models. This interest was brought into sharp focus with the 2008-09 financial crisis where the management and assessment of risk and viability were shown to be lacking. Regulators responded by enhancing risk and viability reporting requirements. The COVID-19 pandemic has created an opportunity to reassess how risks are considered and reported. Through our outreach, investors commented that companies generally communicate opportunities well. However, it is the integration of opportunities and risks and in providing a comprehensive understanding of the risks where company disclosures are not meeting their needs.

Investors look for principal risk and uncertainty reporting that is specific to the company and that avoids boilerplate disclosure and jargon. Investors seek to understand both the principal risks and uncertainties identified by the company and how these are being managed. They gain confidence in management when such reporting is linked to the business model, shows any changes in risk year-on-year and gives some indication of potential impact. They want to understand how the risk management framework and mitigation tool kit have adapted and changed in the face of the COVID-19 pandemic and how those changes more effectively equip the company for an uncertain future. They also need to understand how and where these uncertainties might impact the company and the opportunities and the risks relevant to the company's future.

Uncertainty

Uncertainty is key in any discussion of risks and opportunities. It is relevant in two ways - firstly, in the consideration of the principal 'uncertainties' the company faces, which form part of the principal risks and uncertainties reporting requirement (see Appendix 1); and secondly, there may be specific types of uncertainty, such as an estimation, event or timing and action uncertainty that are inherent in the risks and opportunities themselves.

"Without downside, there is no upside” Investor

Better disclosure would help investors to understand the most relevant uncertainties the company faces, for example through a consideration of these uncertainties in a scenario analysis context, and how the company's risks and opportunities are affected by inherent uncertainties.

The following types of uncertainty were specifically identified in our discussions with companies:

  • Estimation uncertainty – Many companies use models and estimates to help value assets and liabilities, identify potential impacts and provide some directional guide to management. Estimates and models by their nature are subject to uncertainty and this is especially the case where a range of assumptions would have been acceptable. Where such uncertainty exists, investors want to understand what the key assumptions are, what process management has to monitor the appropriateness of the assumptions and how changes might impact the outcome.
  • Event uncertainty (sometimes referred to as Black Swan events) – This is the uncertainty of large and divisive events that could not be predicted (or were deemed highly unlikely to emerge). Examples range from the COVID-19 pandemic, to a sudden emergence of a new, disruptive technology. Where such uncertainty exists, investors want to understand a company's process for identifying such events and how that connects with the ability to respond in the short term, and the company's resilience over the longer term.
  • Timing and action uncertainty – This is the uncertainty that results from an inability to control all actions or the timing of such actions (and reactions). Examples include the negotiations around the UK's exit from the EU, or changes to the competitive landscape. Where such uncertainty exists, investors want to understand the company's key actions and how these flow through to strategy.

Whilst companies are often uncomfortable disclosing the uncertainty they face, it should be considered as part of the whole annual report. Disclosures around uncertainty are not standalone as they connect elements of strategy, risk, viability and resilience.

The graphic summarises the key information that investors told the Lab they want to understand, and which companies should consider reporting. It builds on the work conducted in the Lab's 2017 Risk and Viability report and introduces some 'new' areas raised by investors. However, it is clear that issues identified in 2017 remain relevant.

This report is divided into four broad areas, reflecting what information investors want to understand about risks, uncertainties and opportunities:

  • Governance and processes: which provides an overview of the risk management structures and processes that investors value;
  • Nature: which looks at the characteristics of the information investors want to see;
  • Approach: which highlights the information needs associated with the actions taken to address risks, uncertainties and opportunities and how these impact on other areas of a company's reporting; and
  • Scenarios and stress testing: which looks at how risks, uncertainties and opportunities are reflected in the various scenarios and stress tests conducted by a company.

Risk, opportunity and the code

The UK's Corporate Governance Code recognises that the board is central in identifying, monitoring and managing risks and opportunities. The Code (and guidance) identifies a number of elements that a company can consider to manage risk and opportunities, including:

  • the identification of emerging risks;
  • the integration of risks and prospects over the longer-term into consideration of organisational viability; and
  • the need for risk management frameworks and controls, including a regular assessment of both.

Investors value disclosures that support their assessment of these key elements of governance.

Governance and processes

This may include information about the responsibilities of different groups within the structure, for example the board being responsible for setting and applying the company's risk appetite and the Risk Committee examining the outcome of the work of internal risk management teams and reporting this to the board and others.

"When it comes to risk processes (most companies) have the paints, they are just not painting the picture” Investor

Investors want to understand:

  • What relevant governance structures and processes are in place.
  • How effectively these have functioned.
  • How quickly a company can modify these to react to external factors.

Risk management is only as effective as the processes that underpin it and the governance structures in place to oversee it. Investor participants want certainty that appropriate and effective processes and structures are in place. They also seek clarity regarding the agility and dynamic nature of these to respond quickly to internal and external factors, such as the effects of the COVID-19 pandemic.

'Who' and 'What'

Reporting 'who' is responsible for 'what' in the context of risk management is useful to illustrate accountability for, and management of, different risks within a company. This can be linked to the role of the board and its committees to illustrate how the entire structure is intended to function.

Providing insight into what the board (or delegated entity) has been presented with shows the areas of focus for the different divisions of the company and how these have been considered by senior management. For example, a number of companies discuss bottom-up and top-down approaches to risk management. Better examples provide detail regarding the functions involved in both and their oversight responsibilities.

'How' and 'When'

Understanding who and what is being monitored is only truly useful in the context of how the process is undertaken.

From mitigation to agility

The COVID-19 pandemic illustrated the need for agility in the way companies responded to the difficulties they faced. In many interviews we conducted, companies explained how their risk management process had changed in response to the COVID-19 pandemic. Changes included more frequent meetings, additional 'board time' and focus and, in some instances, a shortening of the decision-making chain. Reporting these changes externally allows investors to gauge how responsive and agile a company can be when facing difficult situations in the future. This reporting should include whether and how such changes influence existing practice or are likely to be incorporated on a longer-term basis (if at all).

Helping investors to understand Extract
What relevant governance structures and processes are in place. Croda International plc
How effectively these have functioned. International Airlines Group plc
Coca-Cola European Partners plc
How quickly a company can modify these to react to external factors. International Airlines Group plc
Coca-Cola European Partners plc

Croda International plc Annual report and Accounts 2020 page 45

What is useful? Croda clearly identifies what is being monitored including current risks (differentiated by category) and emerging risks. The frequency of the meetings of the various groups and the actions taken is also specified, as is the link between the risk structure, risks assessment and the risks themselves.

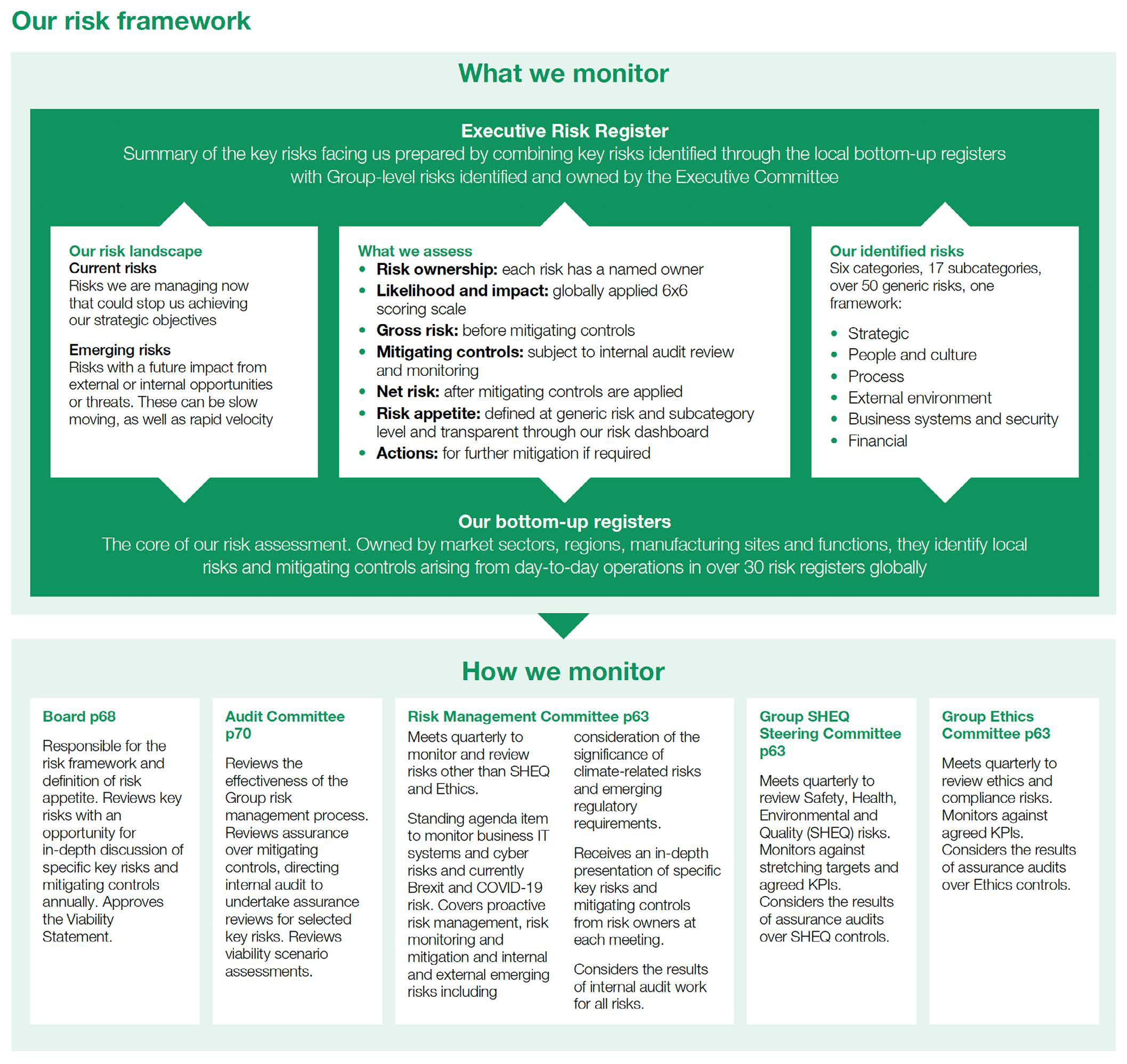

Diagram of "Our risk framework" detailing "What we monitor" (Executive Risk Register, risk landscape, assessment, identified risks) and "How we monitor" (committees).

International Airlines Group Annual Report and Accounts 2020 page 78

What is useful? IAG details the board and its delegates' responsibility in the management of risks. In addition to discussing the risk structure in place, it also identifies the specific changes made in response to the pandemic, their effectiveness and the speed with which such modifications can be made and related benefits of these identified to date.

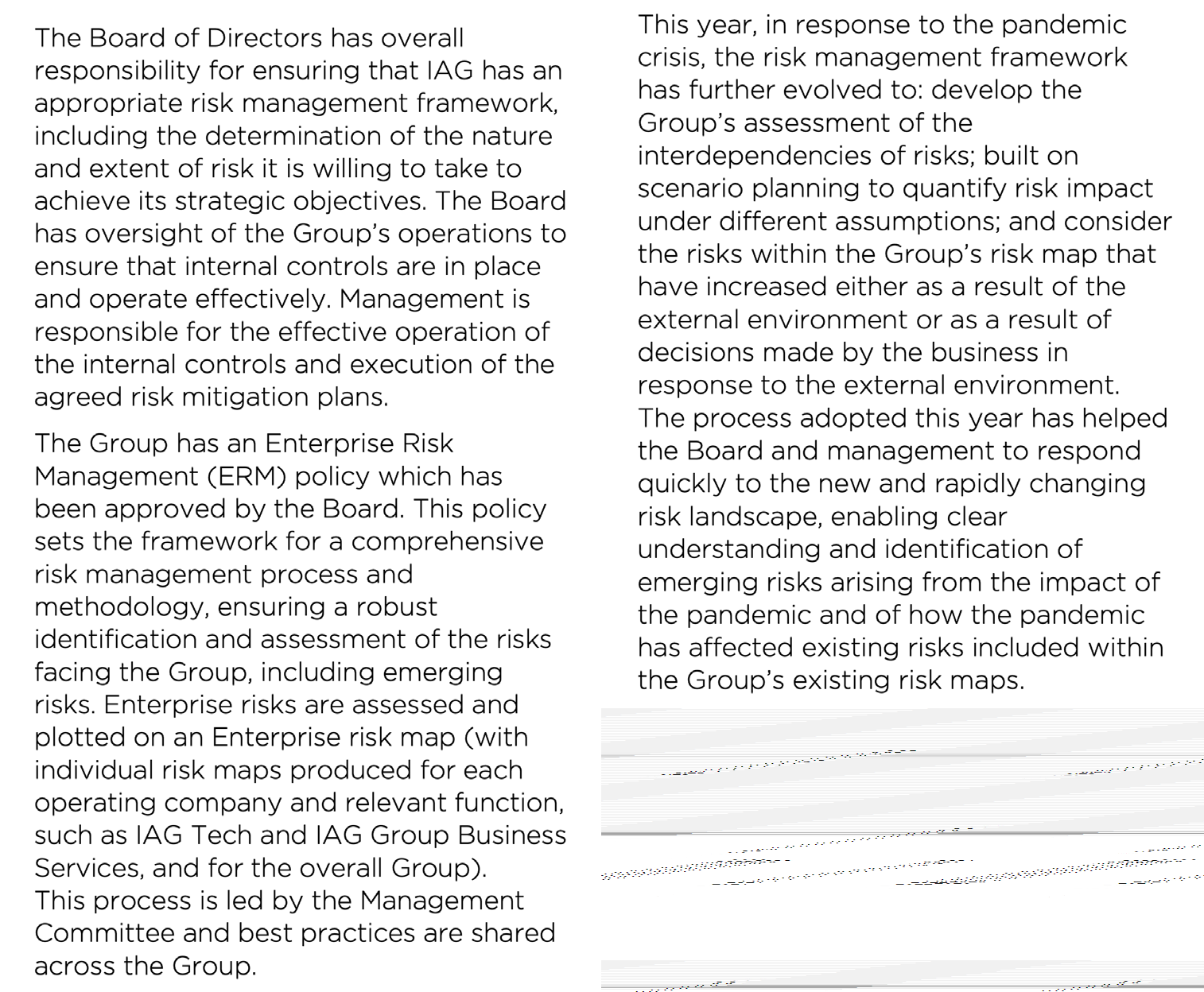

Text discussing the Board of Directors' responsibility for IAG's risk management framework and the Group's Enterprise Risk Management (ERM) policy.

Coca-Cola European Partners plc 2020 Integrated Report and Form 20-F page 51

What is useful? CCEP uses a case study to illustrate its approach to managing the risks associated with the COVID-19 pandemic. It identifies new teams created and adjustments made to established teams and their processes, in addition to the actions taken by the company.

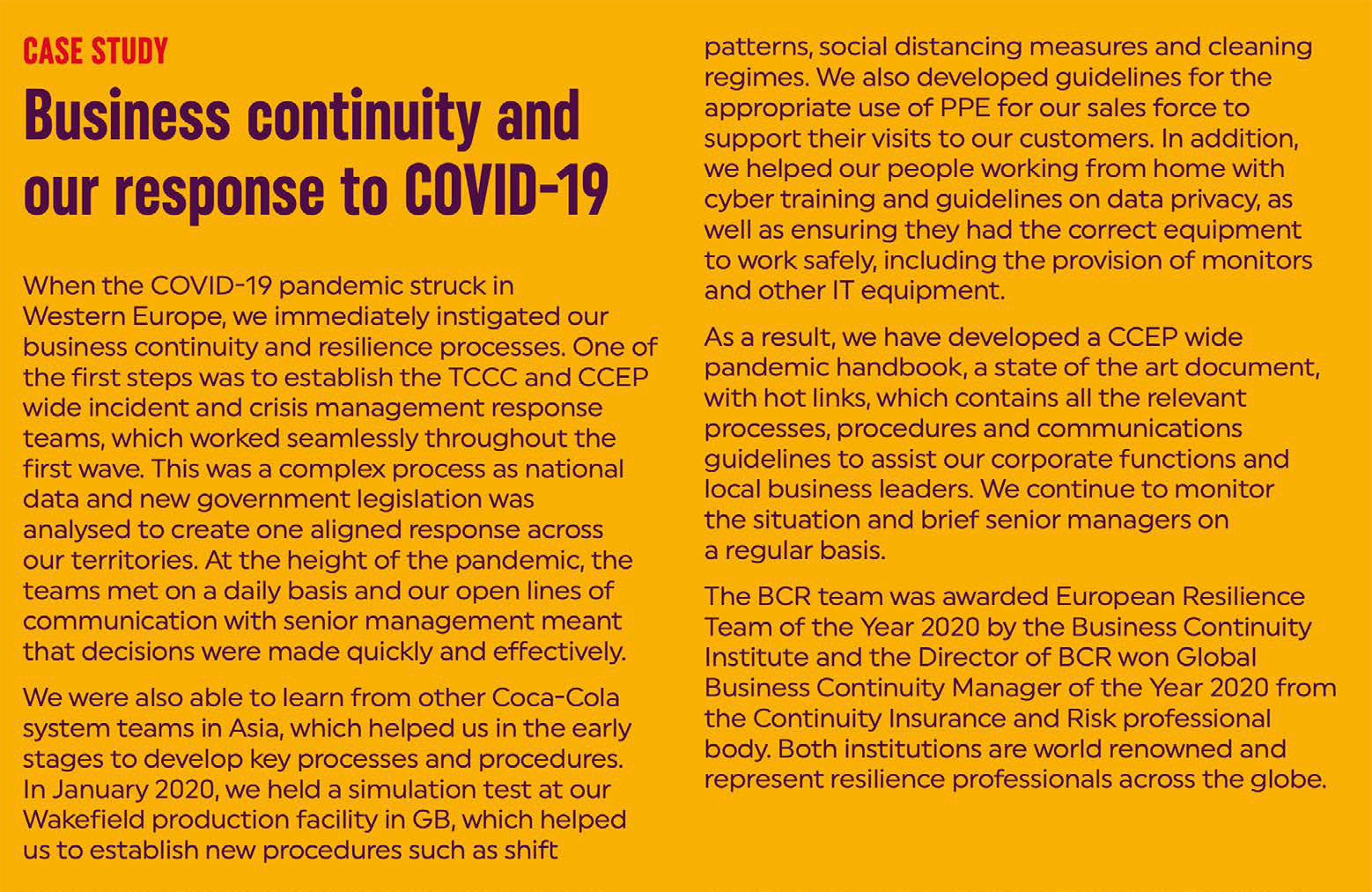

Case study text titled "Business continuity and our response to COVID-19", describing pandemic response, CEEP, and resilience efforts.

Nature

Context

Investors want to understand:

  • The company's view of the macroeconomic, microeconomic and geopolitical environment and the industry-wide risks and uncertainties faced.
  • How the company monitors external factors and how they are incorporated into scenario analysis and planning for the future.

External factors

A significant component of risk management involves monitoring factors, many of which are external to the company, that may impact the company and its operations.

Investors are interested in the company's view of macroeconomic, geopolitical and industry-wide risks as this provides insight into its view of the economic and political landscape. Using these views, in conjunction with their own insights, investors are able to formulate a more complete picture of the environment in which the company operates and how it is responding. Where relevant, a discussion of the opportunities and connected risks identified and whether and how the company plans to exploit, manage and mitigate these adds to investors' understanding of the company.

Scenario reporting should provide insight into a company's horizon scanning process and the effectiveness of its risk identification approach. Reporting of scenarios is further discussed later in this report. Investors are interested in how companies determine when emerging risks and uncertainties are 'escalated to' principal risks and whether any potential opportunities are identified and exploited.

Investors want to understand how the external environment has been considered in the various scenarios reported by companies. Of particular importance is information that allows them to understand the potential downsides associated with external factors considered in the scenarios.

Responding to the COVID-19 pandemic

The COVID-19 pandemic brought with it significant business disruption, both domestically and internationally. Governments responded with increased business support measures. The business landscape and working conditions changed overnight and many companies had to adapt quickly to unprecedented levels of disruption.

Changes to the environment exposed companies to different and sometimes unexpected risks (for example, not many companies foresaw having to consider the risks associated with the majority of their workforce working from home).

In 2020, the Lab produced a series of reports that identified what information investors sought from companies responding to the COVID-19 pandemic. These focused on the key areas investors sought information on, specifically related to resources, action and the future and how companies could enhance their reporting on going concern, risk and viability.

Helping investors to understand Extract
The company's view of the macroeconomic and geopolitical environment and the industry-wide risks and uncertainties faced. Rolls-Royce Holdings plc
How the company monitors external factors and how they are incorporated into scenario analysis and planning for the future. Taylor Wimpey plc

Rolls-Royce Holdings plc Annual Report 2020 page 14

What is useful? Rolls-Royce not only provides its view of the trends evident in its industry, but also illustrates how such general circumstances have specific impacts on its divisions.

Further detail is provided regarding the market environment for each of its divisions, which is linked to the respective risks and opportunities.

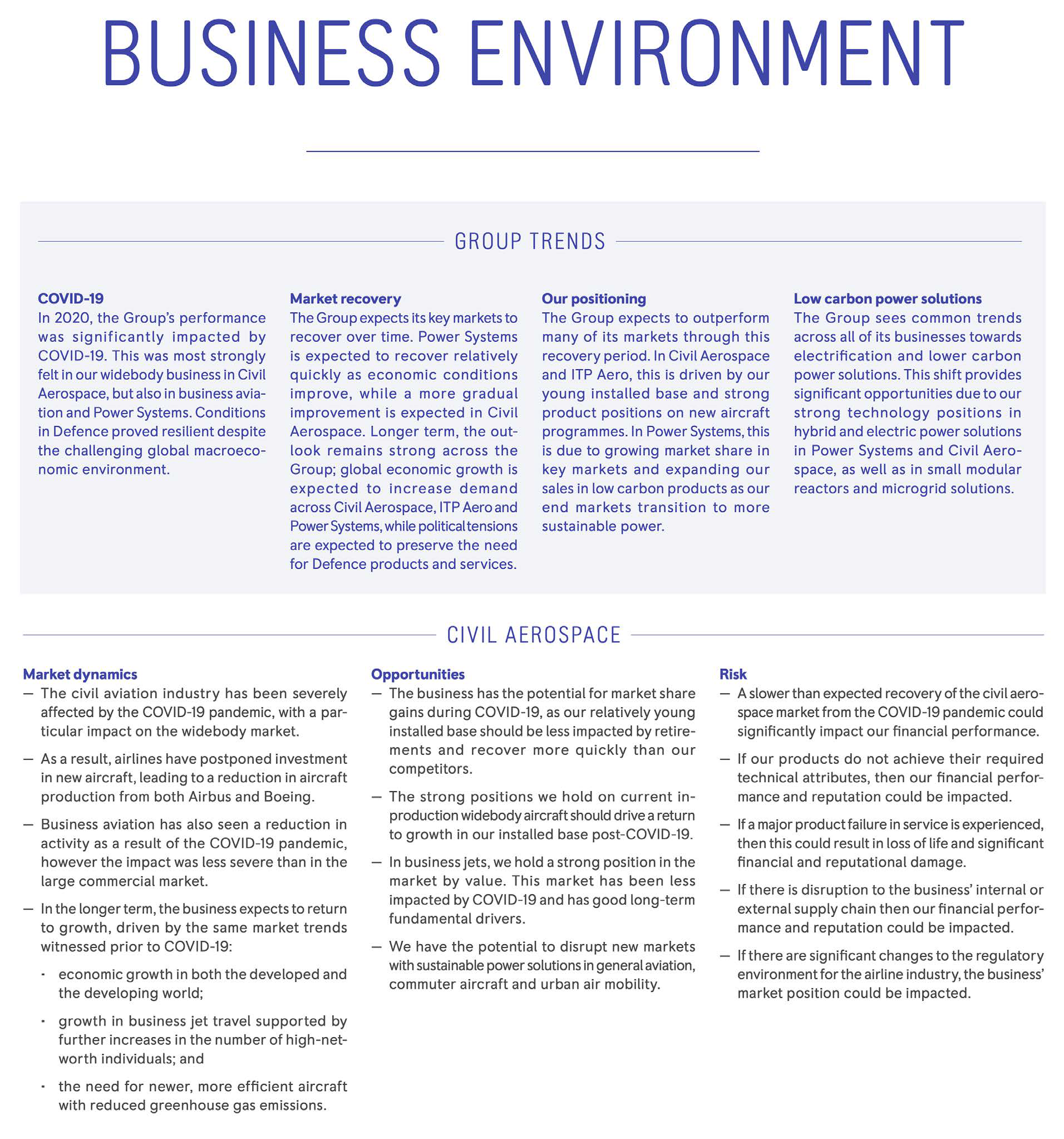

Structured text outlining "GROUP TRENDS" (COVID-19, market recovery, positioning, low carbon power) and "CIVIL AEROSPACE" (market dynamics, opportunities, risk).

Taylor Wimpey plc Annual Report and Accounts 2020 page 8

What is useful? Taylor Wimpey identifies specific aspects of the market environment and why they are important to the company with the '2020 backdrop' illustrating current conditions.

The company describes the expected impact over the short and long term (and links to principal risks), providing an indication of longer-term planning.

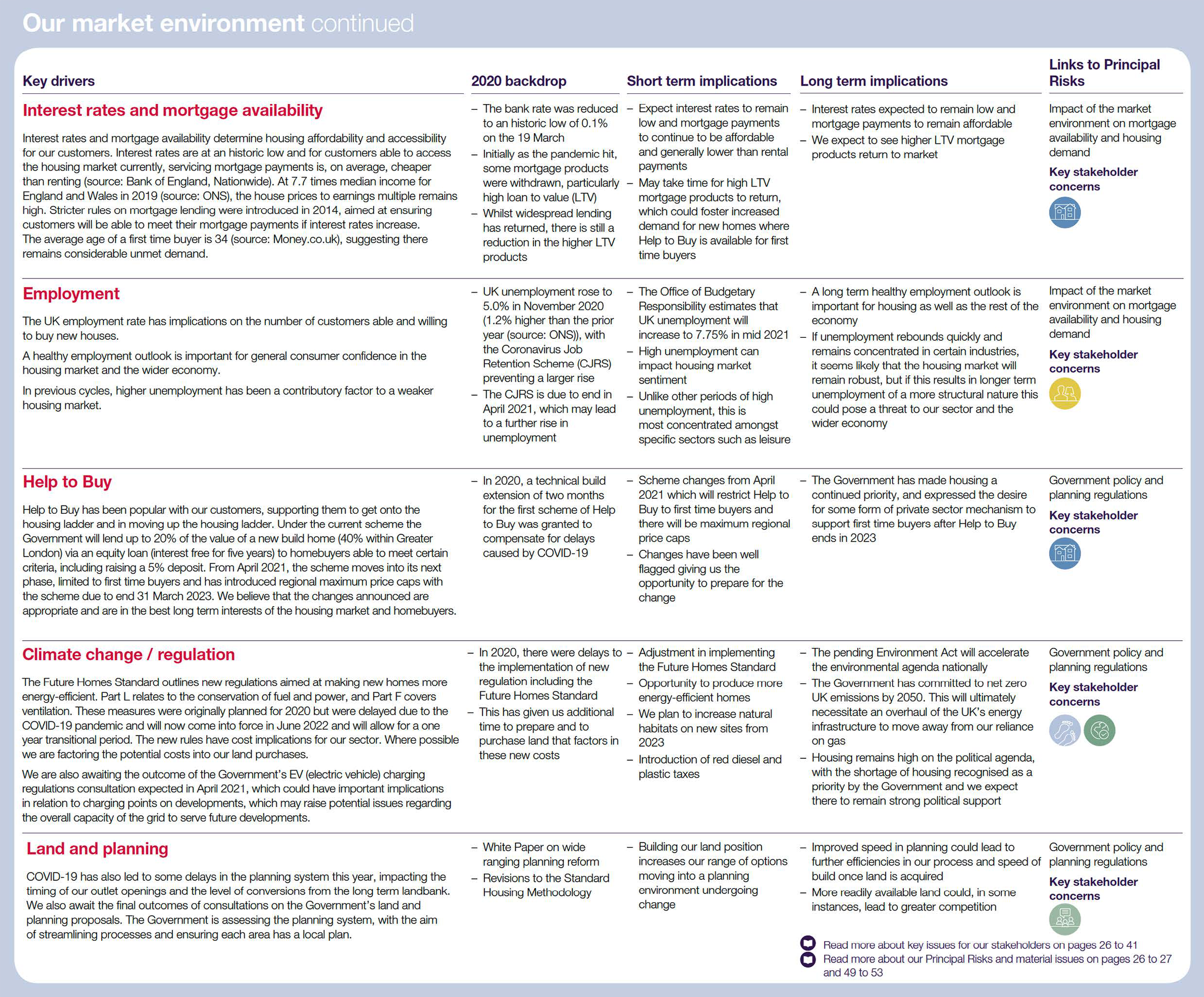

Structured text on key drivers including interest rates, employment, help to buy, climate change, and land planning, with links to principal risks.

Importance

Assessment and changes

A company's assessment of the risks, uncertainties and opportunities it faces provides invaluable insight to investors regarding how the board is considering these. It is vital that risk reporting is company-specific, as this will assist investors to make informed decisions regarding the potential impacts on the company's business model.

Investors are only interested in issues that are material to the company. 'Laundry lists' that indicate all risks and uncertainties faced by the company are not useful. Instead, an explanation of why the risks identified are material and some explanation of the threshold (or thresholds) applied for items to move into or out of the principal risks and uncertainties is helpful – these could be qualitative or quantitative factors. Understanding this movement is also key. Companies that include generic risks in their reports obscure the information that is most valuable to investors.

Indicating the priority or ranking of risks, and the likelihood and impact of risks and uncertainties, provides additional insight into the environment in which the company operates. Some investors said that they value the ranking of principal risks and uncertainties, as this allows them an understanding of the areas of focus and potential concern for management and the board. Others stated that an explicit ranking was not necessary, but it should be clear what areas have been a particular focus for the board. For clarity, it is important for companies to indicate whether the order in which risks are presented is relevant i.e., whether they are presented in order of significance. If nothing is said otherwise, investors presume this to be the case.

Where companies do rank risks, some present their rankings numerically in the risk table and others use risk matrices. Ranking changes should be consistent with any changes to, or trends in, the risks reported.

Likelihood and impact

Discussion of the likelihood and impact of risks is of particular interest to investors. They want to understand the potential downsides associated with the risks and uncertainties, but also any opportunities that have been identified during the process.

Some investors would like to see quantification of principal risks (where possible) and more granular detail regarding what part of the company or group is likely to be impacted, for example, by specifying the segment or business unit likely to be impacted and its relative size.

Investors expressed no preference between reporting of risks gross or net of mitigations, but companies should be clear which is being reported.

Viability

There is scope for additional linkage between likelihood and impact disclosure and other reporting. Potential impact on the company's business model, viability and resilience is of interest to investors, especially in terms of the effectiveness of mitigating activities and other measures put in place to cope with events that may not be 'mitigatable' or are considered to be low likelihood but high impact (for instance the COVID-19 pandemic).

Where principal risks are included in scenario and stress testing for the purposes of the viability statement, clearly indicating this (through use of a symbol, for example) and the assessed impact of the individual or group of risks is useful.

A step ahead: reporting using time horizons

As many companies prepare to report in line with the Task Force on Climate-Related Financial Disclosures (TCFD) recommendations under new listing rule requirements, the reporting of information over multiple time horizons is becoming more prevalent. This provides an opportunity for companies to integrate 'risk reporting' with longer-term viability and business model resilience reporting to provide investors with a more holistic view of management and the board's understanding of and planning for the longer term.

We expect that this move towards a more time-focused reporting framework will lead to companies experimenting with different and more innovative ways of reporting. Next provides an interactive spreadsheet model to project key aspects and assumptions out to 15 years. This interactive approach allows users to understand the cumulative impact of trends over the longer-term. This type of reporting may become a crucial tool in communicating the long-term prospects and business cases for a company.

Helping investors to understand Extract
The company's assessment of the importance of the risks, uncertainties and opportunities faced, and why it has changed. TUI AG
Spirax-Sarco Engineering plc
The likelihood and impact of the risk, uncertainty or opportunity. TUI AG
Croda International plc
Whether the risk or uncertainty has been considered as part of the company's viability assessment. Croda International plc

Common reporting techniques

Given the vast amount of information to be reported, companies have sought the most effective and efficient reporting formats for risks. The two that are used most commonly (either one or both) are risk tables and 'heat maps'.

  • Risk tables: Risks and uncertainties are most commonly presented in a tabular format. This format is useful as it allows for other information to be presented clearly alongside the risk information itself.
  • 'Heat maps': Many companies make use of a graph that primarily depicts the likelihood and impact of their principal risks. In addition to mapping the current year estimated impact and likelihood of risks and uncertainties, movements from the previous year can be depicted and the relative significance of the items can be identified.

Both have advantages and disadvantages from an investor perspective and both could be more useful in meeting investor needs. To be truly effective, companies should provide explanatory narrative (as information is not always precisely depicted) and quantify information provided within both of these reporting forms.

A step ahead: Opportunities for digital

The Lab's recent work on Video and Virtual and Augmented Reality has shown that modern communication technologies are increasingly providing investors and other stakeholders with an opportunity to engage differently with company reporting. Whilst often such tools are used to communicate strategy or wider ESG topics, there is also an opportunity to communicate risks and mitigating activities. Digital visualisation tools allow users to gain insight into a risk that might be difficult to communicate using more traditional two-dimensional charts, graphs and heat maps.

Beazley plc New world, new risks: How are businesses' attitudes to risk & resilience changing? page 2

What is useful? Whilst not used in an annual report context, this risk matrix provides an example of how the relationship between risk and resilience can be depicted.

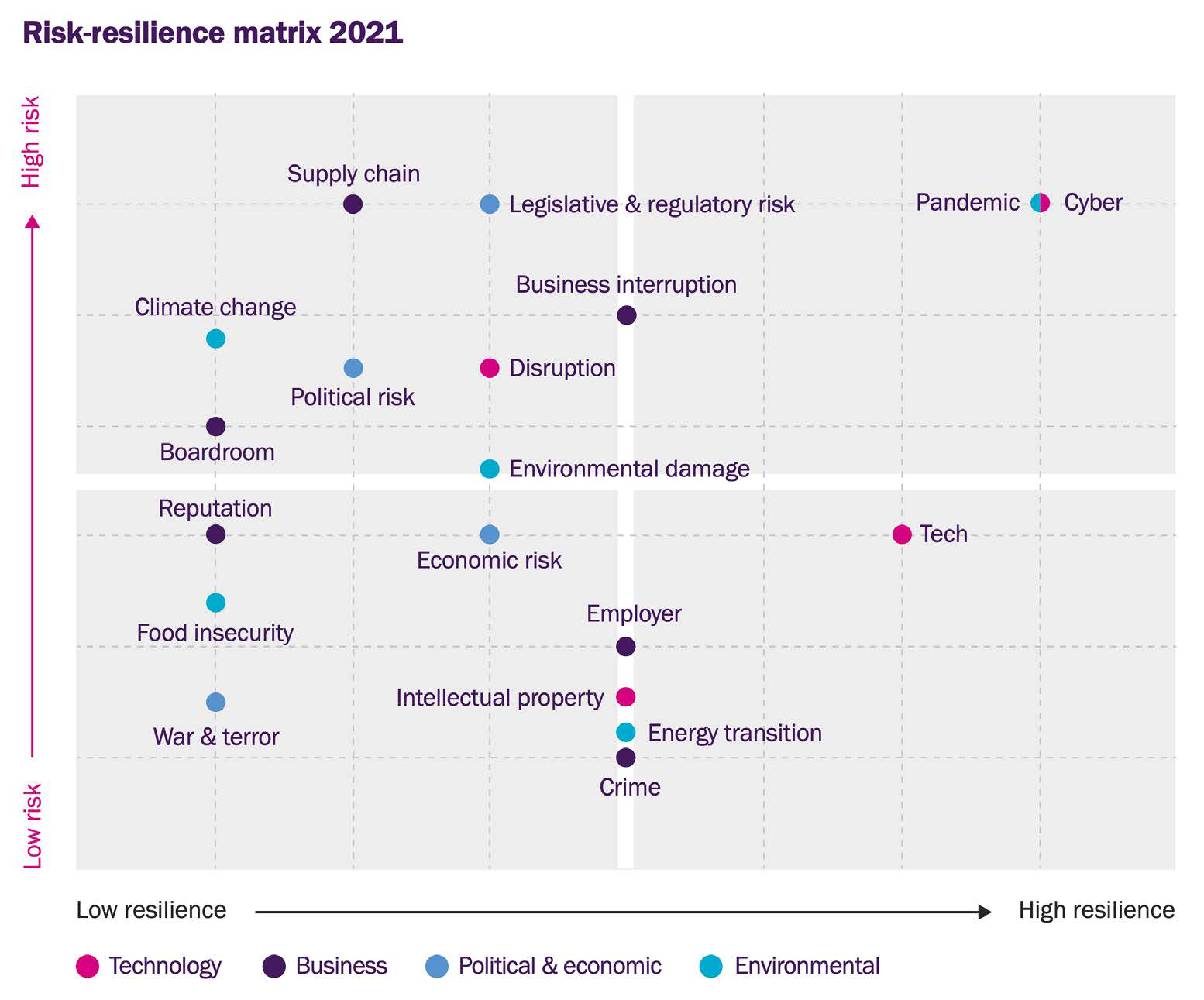

Risk-resilience matrix for 2021, plotting various risks (e.g., supply chain, pandemic, climate change) against low/high risk and low/high resilience axes, categorized by type.

TUI AG Annual Report 2020 page 37

What is useful? TUI shows not just the current principal risks but also how they compare to wider macro risk. The company also shows its target for the risk, which includes mitigations and other actions.

Principal Risk Heat Map showing active and monitored risks plotted by impact and likelihood, with current and target risk positions defined.

Spirax-Sarco Engineering plc Annual Report 2020 page 62

What is useful? Spirax-Sarco has used its 'risk table' to identify individual risk appetites and the company's rationale for such ratings.

Spirax-Sarco provides a description of the reasons for any changes (emphasised) to the significance of the risk. The identification of the risk sponsors highlights accountability within the company's risk management framework.

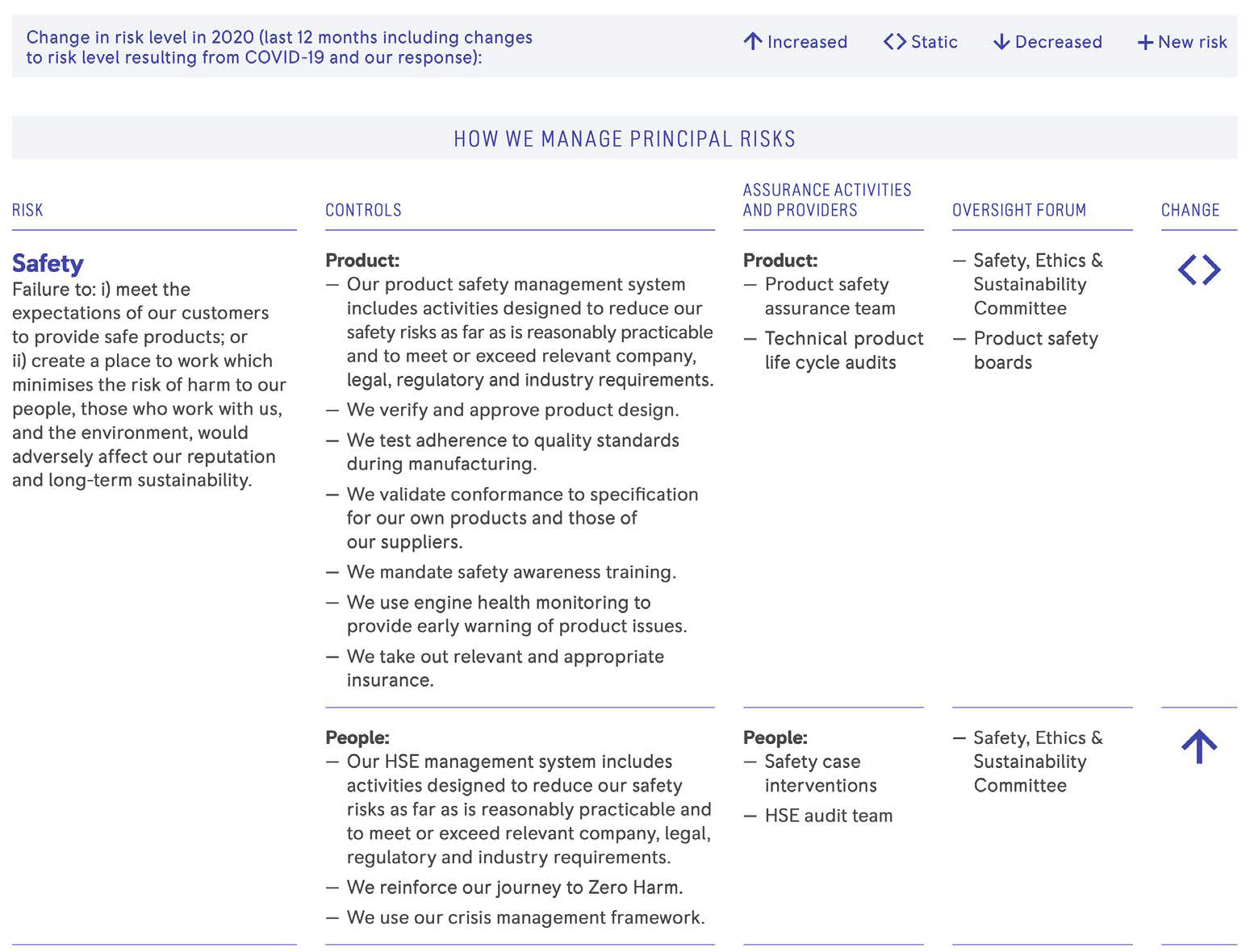

Principal risks The following table sets out the Group's principal risks and describes the links to strategy, the mitigation measures and the appetite for each risk. The trend column sets out the direction of change from 2019.

The table includes those risks that we have identified as currently most relevant to the Group.

Key Trend * (↑) Increased risk * (☑) No change to risk * (✓) Decreased risk

Link to strategy * Direct link * Indirect link * No link

Risk appetite ratings defined:

Rating Description
Very low Following a marginal-risk, marginal-reward approach that represents the safest strategic route available.
Low Seeking to integrate sufficient control and mitigation methods in order to accommodate a low level of risk, though this will also limit reward potential.
Balanced An approach which brings a high chance for success, considering the risks, along with reasonable rewards, economic and otherwise.
High Willing to consider bolder opportunities with higher levels of risk in exchange for increased business payoffs.
Very high Pursuing high-risk, unproven options that carry with them the potential for high-level rewards.

Table defining risk appetite ratings and detailed analysis of "Economic and political instability" principal risk, including mitigation, change, rating, and rationale.

Croda International plc Annual report and Accounts 2020 page 47

What is useful? Croda links risks to its business model and strategy while explaining the importance of this link. It also sets out the responses to the risk, including examples of actions taken during the period and whether there was any impact of COVID-19.

Visual framework outlining key risk areas like people, process, manufacturing, and supply chain, linking them to strategy and business model with icons and detailed descriptions.

Why this matters to us

Retaining and developing the experience and motivation of all our knowledgeable and diverse employees is critical to maintaining our ability to deliver our strategic priorities. Failing to maintain our distinctive Croda culture within which people thrive and which attracts new and diverse talent to join the Company would significantly damage our ability to innovate and grow.

How we respond

A clear Purpose, strong development culture, excellent learning opportunities and competitive reward programmes support the retention, engagement and career development of the high-quality teams we need. Global graduate and management development programmes include stretching and high-profile assignments and provide a pipeline of internal talent.

Our bi-annual global talent review process considers resources and succession plans for critical roles, with actions monitored by the Executive Committee and the Board.

We sell into a number of highly regulated applications. Non-compliance with our customers' stringent product quality requirements, global and local regulation could expose us to liability claims, significant reputational damage and compromise our ability to grow, especially in light of our commitment to expand to grow Life Sciences.

Monitored by our Group SHEQ Steering Committee (p63), our sites and products are certified to demanding external quality standards highly valued by our customers (including ISO 9001, GMP and Excipact). Our global network of quality professionals enforce compliance with the Group Quality manual, assured through internal audits delivered by our specialist Group Quality audit team and external certification audits. We work proactively with relevant trade associations to shape future regulation.

We rely on the continued sustainable operation of our manufacturing sites around the world.

Climate change directly impacting the location of a site or availability of utilities used, or a major event causing loss of production and violating safety, health or environmental regulations, could limit our operations. This could also expose the Group to liability, cost and reputation damage, especially in the light of our commitment to sustainability and customer service.

Monitored by our Group SHEQ Steering Committee (p63), our global network of site-based safety professionals enforce compliance with global policies and procedures defined in the Group SHE manual. Assurance is provided by the specialist Group SHE internal audit team, whilst external auditors certify our compliance with international safety standards. Our sites are certified to ISO14001 standards.

Risks specific to each site are identified in 'bottom-up' risk registers and local business continuity plans are in place which are regularly tested.

Sourcing from suppliers who do not share our ethical stance could lead to reputation damage, especially in the light of our sustainability commitment.

Any interruption in the supply of key raw materials would affect our operations and financial position. Such a disruption could arise from market shortages, climate change impacting the locations where bio-based raw materials grow or

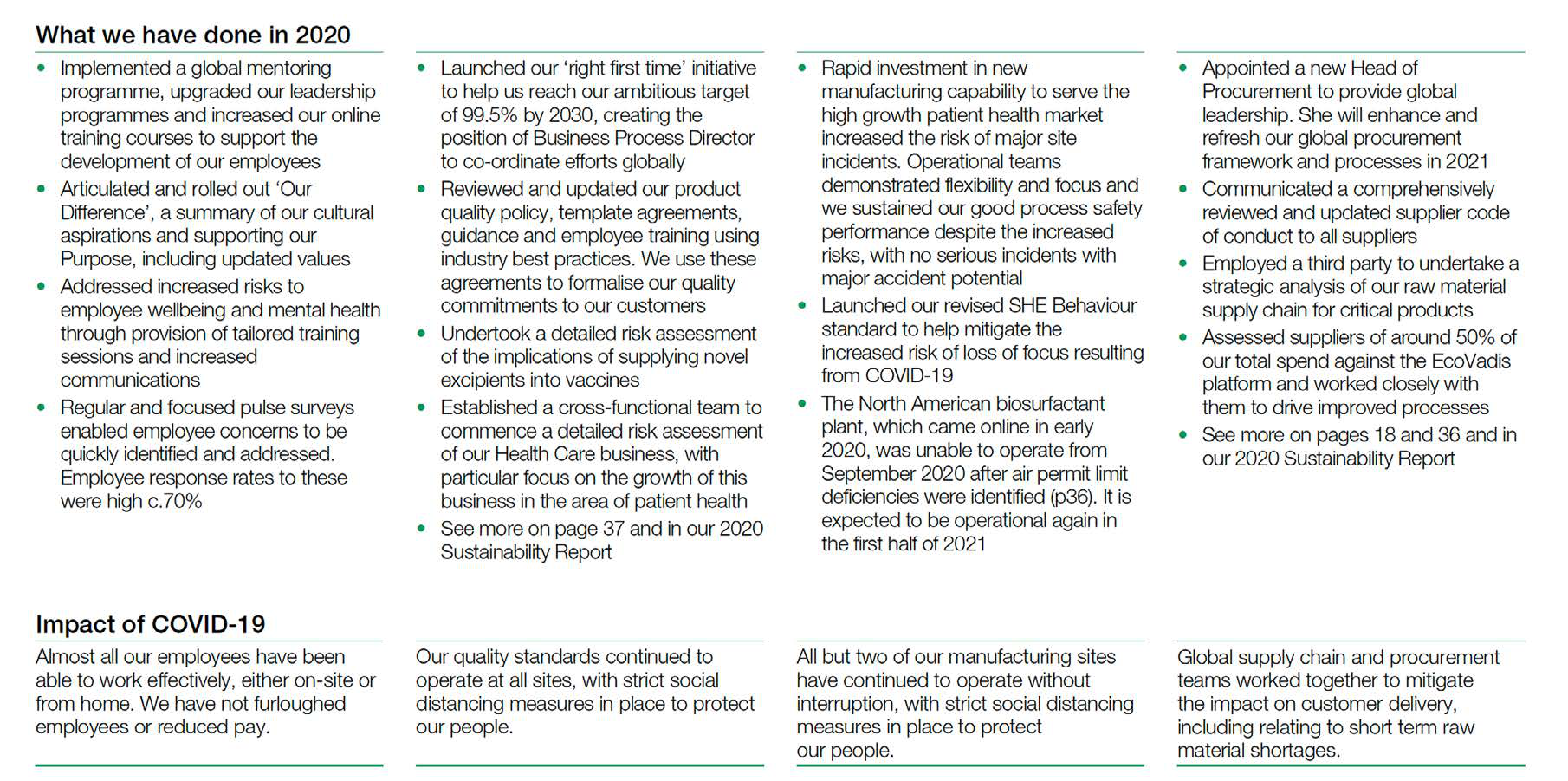

List of 2020 achievements, including global mentoring, leadership programs, product quality, and supply chain management, plus the impact of COVID-19.

Form

Investors want to understand:

  • What category of risk or uncertainty the company faces, for example, internal, external, strategic, operational or financial.
  • How a company's classification of risks links to other areas of the report.

Categorisation

Grouping risks by themes or categories provides investors with insights into how management and the board consider and manage risks. This allows for external evaluation of the risks and how these are considered within the context of a company's business model and strategy.

Groupings could include: strategic, operational, financial, internal or external risks. Investors value categorisation of company-specific and general (industry-wide) risks as this allows them to compare companies more easily.

Linking to other areas of the report

Categorisation has many potential benefits in terms of linking of information through a company's annual report.

Effective grouping and categorisation may lead to better and more consistent reporting of:

  • The impact on a company's business model, strategy and, longer-term viability: This impact can be presented in a more connected way across the report.
  • Mitigating actions and strategies: These often apply to several risks rather than to single risks. Collective explanations are more succinct and provide greater insight into how risks are being mitigated on a collective basis.

Risk cascade

One event or sequence of events can have an impact on a number of areas of a company and its operations and, therefore, the risks that it faces. This is something that multi-factor scenarios within the viability statement consider to an extent. However, information about such 'risk cascades' is often missing from the disclosures on the risks themselves even though there is a direct link to the company's risk appetite, mitigations and the likelihood and impact of the interrelated risks.

Helping investors to understand Extract
What category of risk or uncertainty the company faces, for example, internal, external, strategic, operational or financial. Henkel AG
Essentra plc
How a company's classification of risks links to other areas of the report. PageGroup plc

PageGroup plc Annual Report and Accounts 2020 page 42

What is useful? PageGroup shows how principal risks are considered in the context of the company's strategy, providing the link between risks and strategy.

Diagram showing risk categories: Strategic, People, Operational, and Financial, with associated risk types like business model shift, cyber security, and foreign exchange.

Major risk categories

Risks are presented from a net perspective, i.e. with their respective mitigation measures taken into account.

Overview of major risk categories

Table summarizing major risk categories (Operating, Functional, Environmental, Business strategy), their probability, and potential financial impact.

Major opportunity categories

Entrepreneurial opportunities are identified and evaluated at Group level and in the individual business units, and duly incorporated into the strategy and planning processes. We understand the opportunities presented in the following as potential future developments or events that could lead to a positive deviation from our guidance. We also assess the probabilities of price-related procurement market and financial opportunities.

Detailed descriptions of major opportunity categories, including procurement, macroeconomic, financial, acquisition, and research and development opportunities.

Henkel AG Annual Report 2020 pages 154 and 155 and page 164

What is useful? Henkel uses its risk categorisation to illustrate the assessment of the likelihood and impact of the risks.

Using these categories, it also identifies opportunities and provides further detail such as the estimated impact for the company.

Essentra plc Annual Report 2020 pages 52, 55 and 58

What is useful? Essentra clearly defines the categorisation of its risks. These categories are used consistently throughout the risk section, including the risk map and in the description of each risk. Emerging risks are clearly provided and contextualised and the specific actions taken as mitigations in the year are indicated.

Two tables detailing risk categories, emerging risks, their controls, and strategic risk related to tobacco industry dynamics.

Approach

Linkage

Investors want to understand:

  • Impacts in the context of a company's business model, strategy and purpose and whether and how key performance indicators (KPIs) and other metrics are tailored accordingly.
  • The company's assessment relating to its viability using more company-specific information that relates to longer time periods.

Impacts and context

Consistent reporting is important to investors and the information they are presented with should form part of a coherent package that is easy to digest and supports decision-making. Unfortunately, in many instances, risk reporting is a standalone section of the annual report. There are several areas where investors expect overlap to exist and where disclosure would be useful.

The Lab has considered business models a number of times, including in the Business model report and implementation study. These reports suggested that the business model or strategy is the base from which to link other parts of the annual report – not the principal risks. Therefore, a company should show how principal risks link to these areas.

In our discussions with companies, it was noted that, as a result of the COVID-19 pandemic, the risk function and risk-related discussions were receiving greater emphasis at several levels, including at the board level.

Investors, too, highlighted a slightly different focus as a result of the COVID-19 pandemic - the principal risks were often the starting point when analysing a number of company reports. In other words, a 'risk report outwards' approach was followed. Reporting should clearly identify and explain how the external and internal environment and the associated risks, uncertainties and opportunities affect the company's business model, strategy and viability. Links to company decisions and KPIs provide a more integrated picture of the company.

Our discussions identified many instances where companies' external reporting did not adequately reflect the extent and quality of their internal processes and activities. Investors reiterated that the annual report is their primary source of information regarding risk reporting. They also noted that, given the challenges faced over the COVID-19 pandemic, they would expect companies to reflect on any changes made to processes or a discussion on how effectively existing processes helped in times of stress.

Viability statements

Through our discussions with companies (for this report as well as the 2017 report), it was clear that the introduction of the viability statement led to enhanced internal processes and discussions relating to 'viability' and the assessment of risks (particularly those that relate to liquidity and solvency).

However, in many instances, these processes and discussions are not reported externally. Investors still consider the information reported in many viability statements to be too generic and short-term in nature to support effective stewardship and decision making.

Unfortunately, the viability period selected is often inconsistent with other time horizons used elsewhere, including strategic and business cycles, debt repayments, lease periods, goodwill impairment, capital investment periods and technology development periods.

Resilience statement

One of the recommendations made in the Brydon review was the resilience statement and this recommendation was discussed in further detail in the BEIS consultation on 'Restoring trust in audit and corporate governance'. The proposal is that this statement incorporate the current going concern requirements, develop further the existing UK Corporate Governance Code-based viability statement requirements and expand further into discussions regarding the longer term.

While the requirements have yet to be set out in detail, the resilience statement is likely to require companies to set out how they are preparing to be resilient over the short term, medium term and the longer term in the face of principal and emerging risks specific to the company, and other uncertainties.

The aim is for reporting to be more specific to companies and allow for greater consistency in the reporting of risk and resilience. This would necessitate companies to identify and provide specific elements of reporting relating to the material risks that they face.

As the findings of this report have shown, investors value company-specific information and would value such information over longer time horizons. While this may be challenging for companies, such reporting is expected to lead to additional useful information. Further, like the introduction of the viability statement, the introduction of a resilience statement may lead to enhanced internal processes, which will aid companies better to assess their resilience to threats to their business models.

Helping investors to understand Extract
Impacts in the context of a company's business model, strategy and purpose and whether and how key performance indicators (KPIs) and other metrics are tailored accordingly. Croda International plc (page 18)
The company's assessment relating to its viability using more company-specific information that relates to longer time periods. Next plc

Next plc Annual Report and Accounts 2021 page 77

What is useful? Next maps various aspects of the actions or functions that contribute to the management of the company over the short, medium and longer term. These are useful for a fuller understanding of the time horizons associated with how the company is managed and are used to add context to the selected viability period.

Assessment period The retail sector is inherently fast paced, competitive and dynamic, particularly in respect of the fashion product cycle. However, as illustrated in the diagram below, a wide variety of other time horizons are also relevant in the management of the business.

The directors have assessed the viability of the Group over a three year period, as they believe this strikes an appropriate balance between the different time horizons which are used in the business and is a reasonable period for a shareholder to expect a fashion retail business to be assessed over.

Timeline diagram showing various business activities like budgets, payback periods, cash flow forecasts, and pensions across 1 to 10+ year assessment periods.

Response

For planned or possible actions, investors want to understand the timing of these activities and how they will impact the risk over the longer term.

For example, the COVID-19 pandemic crystalised a number of risks for many companies. To mitigate these risks companies quickly adopted a number of shorter-term changes such as full cloud working and emergency capital raising. Investors valued details about these actions, but also wanted to understand what longer term actions the company was putting in place (and the cost and timing of these) to mitigate risks highlighted by the pandemic such as supply chain weakness.

These new 'agile risk toolkits' are likely to become increasingly important in mitigating the impact of short-term risks. Any 'new' mitigating activities deserve disclosure and these are also likely to tie into how a company might consider resilience and viability.

Investors are also interested in how effective previously implemented mitigating actions have been and what changes are being made as a result of learnings from the past. These planned actions and activities illustrate how responsive and agile the process adopted by the company is to external and internal drivers.

Mitigating actions and activities may be applied to a number of the company's principal risks and uncertainties. Therefore, it would be useful to indicate which risks the actions are intended to mitigate. Effective grouping of risks and uncertainties may help to reduce repetition of reporting and better illustrate a company's net risks.

Mitigating activities and actions

Company mitigating activities are often a list of options rather than concrete actions that have been undertaken, will be taken, or might be taken, and as such this type of disclosure is not very useful to investors. Investors want to be able to judge how the actions already taken have impacted the risk and also want to understand how future actions might drive the net risk over the longer term.

Where the company is covering actions that have already been taken investors want specific details with timing and cost (where appropriate), how this has fed through to net risk and how this positions the company versus residual appetite for the risk.

Stakeholders and risk

Most reporting of risk by companies is focused on the internal impact that the risk would have on the company and its operations rather than the risk to those impacted by the company's operations.

In the Lab's Reporting on stakeholders, decisions and Section 172 report, investors indicated that they value an understanding of risks (and related mitigating activities) that could affect key stakeholders and the company's relationship with them and any related opportunities. Further, they want to understand how companies take risks and opportunities into account when making decisions as they strive to meet their purpose and fulfil their strategic objectives.

Risk appetite

Where companies have provided disclosure of risk appetite, it is often a high level narrative rather than numerical. The COVID-19 pandemic has shown many companies that, whilst a static or fixed appetite is useful for planning purposes, in reality it needs to be dynamic. This dynamism reflects both the issues and the mitigations which become available, and reflects the reality of some 'black swan'2 risks companies face. This is a difficult area for disclosure, therefore something like a case study, or insights gathered through the consideration of a range of scenarios, might provide more insight into how the company has developed its risk appetite.

Some investors suggested that if precise thresholds are not provided, acceptable ranges would be a helpful alternative. For example, many companies would have considered significant home working to be outside the risk appetite of the organisation, but this changed when there was no alternative. Similarly, the amount of government support created options which allowed companies to operate outside of the 'standard' risk appetite.

Investors would also value an explanation of changes to risk appetite over time and whether it varies depending on the 'type' or 'category' of risk and uncertainty (i.e. where multiple risk appetites exist). Such an explanation would provide investors with insight into the company's underlying processes and controls. Ultimately, this would provide a better understanding of the actions a company is likely to take to mitigate risks or to take advantage of opportunities that may arise should a greater level of risk be tolerable.

Evolution

Risk reporting is forward-looking in nature, therefore its likelihood and impact and the mitigating actions a company plans to take must be reassessed throughout the period (and reported externally at least twice per period for many companies).

Nevertheless, reflection on decisions and expectations of the past and how these altered companies' decision-making and processes is of use to investors. Investors want to understand companies' assessments of how risks are expected to move. This can be depicted in several ways in the risk table or the risk heat map. Simply stating that a 'risk has increased/decreased/remained the same' in isolation is not useful – investors want to understand the significance of the change (if any), what led to that assessment, whether further changes are expected, and what actions the assessment led to.

When explaining the driver of the change, detailing whether this was an internal or external factor, provides further insight into how effectively management and the board reacted to and managed the situation. Where a change in the assessment of a risk leads to an opportunity, it would be useful to explain this and how the company plans to take advantage of the opportunity.

Company 'risk language'

Risk reporting is an area where there are a number of externally identified terms and concepts (such as principal risks) as well as a company's own risk-related terminology. It is important for a company to define the terms used and the relationship between them to allow users to understand them and to compare across companies and organisations that may use different terms or use a term differently.

Emerging risks

Of particular interest are those risks not yet considered to be 'principal', but which have been identified by companies' horizon scanning and other processes, such as scenario analysis.

Commonly referred to as 'emerging risks', these are risks that may, in time, pose a threat to a company's business model. The term 'emerging risks' may be interpreted differently and companies that define what they mean by 'emerging risk' assist users better to understand the context of this reporting.

The UK's Corporate Governance Code requires the board to carry out 'a robust assessment of the company's emerging and principal risks' and in 2019 the FRC also called on companies to disclose the potential impact of emerging risks on future business strategy. However, given that these risks are more unpredictable or have a greater level of uncertainty, there may be less relevant data or detailed information available. This places greater importance on ensuring that investors understand the process followed to identify such risks and how the company is considering and preparing for the future.

Investors expect an explanation of these risks and any mitigating activities currently in place (or to be put in place) to address them and who has responsibility for their continued monitoring. They would like to understand the anticipated timeline associated with these risks i.e. when they are anticipated to be significant to the company, why they would be considered to be significant by the company (i.e. considered for reporting as a principal risk) and what would lead them to be considered to be significant.

Providing greater insight into the past

Investors expressed interest in companies' assessments of the past risks it faced and how these were mitigated, including how these may affect future actions. These could be included in the form of a case study or 'risk management in action'.

Opportunities - Describing past opportunities upon which the company previously capitalised provides users with 'evidence' that opportunity-identification processes are in place and are effective without compromising the company's commercial advantage.

Risk crystallisation - Reporting on risks that crystallised during the period is encouraged in some jurisdictions other than the UK. Reflection on how well these were managed and lessons learned could be valuable.

Industry/regulator perspectives

Whilst detailed emerging risks relevant to a company and its business model should be considered specifically for each entity often industries share some common emerging risk areas. The Joint Forum on Actuarial Risks (JFAR) is a collection of five regulators (with the FRC being one of those regulators) who on an annual basis publish a Risk Perspective on current and emerging risks for those within the actuarial profession. Such approaches can provide useful tools for companies to triangulate their own emerging risks.

Helping investors to understand Extract
Factors a company considers when determining or changing its risk appetite. Foxtons Group plc
Mitigating actions and strategic activities so as to assess how the company may respond to risks and uncertainties in the future. Rolls-Royce Holdings plc
Essentra plc (page 21)
Whether, how, and why risks have evolved over time. Spirax-Sarco Engineering plc (page 17)
Essentra plc (page 21)
PageGroup plc

Foxtons Group plc Annual report and accounts 2020 page 31

What is useful? Foxtons provides a risk appetite statement and illustrates how this applies to different types of risk, with ratings and explanations. Providing the risk assertion and parameters applied gives insight into the underlying assessment and processes.

Table describing risk appetite, categorizing risk types (Strategic, Financial, Operational, Compliance) by assertion, parameter, and appetite level.

Rolls-Royce Holdings plc Annual Report 2020 page 47

What is useful? Rolls-Royce's explanation is divided into useful components which clearly identify the controls in place, who executes the controls and associated assurance. The subdivision of the controls by 'type' provides richer information.

Change in risk level in 2020 (last 12 months including changes to risk level resulting from COVID-19 and our response): ↑ Increased <> Static ✔ Decreased + New risk

Table detailing principal risks (Safety, People), their controls, assurance activities and providers, oversight forums, and change in risk levels.

PageGroup Annual Report and Accounts 2020 page 46

What is useful? PageGroup has provided detail and application of the 'Significant influencing factors' associated with risks (in this instance cyber security) in a way that is company-specific.

Information on cyber security, outlining the nature of risk, significant influencing factors, and a stable net risk level with an arrow icon.

Cyber, data and digital risk

Like climate change, cyber, digital and data risks are becoming a topic of enhanced focus. The technological acceleration of companies' business models driven by the COVID-19 pandemic now means that almost every company will face some type of cyber, data and digital risk (collectively or individually).

As part of this project our discussions with companies identified that those at the leading edge are developing new ways to monitor and manage such risks. The Lab is undertaking a deep-dive into this risk area to understand current practice, approaches and disclosures. If you would be interested in taking part in such a project please email us at: [email protected]

Scenarios and stress testing

Investors want to understand:

  • The different scenarios and situations considered, and stress tests performed, and how these tie into other areas of reporting and the company's view of the future.

There are a number of areas of reporting that encourage the consideration of scenarios and stress tests. These include the viability statement, the TCFD recommendations, financial reporting frameworks and the proposed resilience statement.

Investors find disclosures relating to scenarios and stress tests useful given that they provide insight into areas that are highly uncertain and cannot necessarily be calculated precisely. More companies have started providing such information, however, what is provided is often at a high-level and, in many instances, inconsistent with other information provided in the annual report. Instead, scenarios provided within the context of the viability statement should be consistent with the estimates and judgements applied in the financial statements and with narrative around the company's strategy, longer-term outlook and related impacts on its business model. The FRC's climate thematic, for example, found that there was very little evidence of the linkage of the scenarios reported in the front half of the annual report and the information in the financial statements.

Narrative showing how scenarios tie to principal risks is also useful to investors. A number of companies indicate which principal risks have been considered in scenarios in the viability statement. However, few describe why those that have not been included have been omitted. Further insight into risks with material qualitative impacts (i.e. those that may not be quantitively material) and, where relevant, tying in the likelihood and extent of the mitigating activities to the scenario analysis is also considered to be useful.

Rather than disclosure on numerous scenarios or many iterations of a single scenario, investors want disclosure on those that are deemed to be material by the company. Similarly, investors want to understand that the stress test conducted by a company has identified the singular most significant item that could lead to the company 'failing'.

Scenarios are not expected to be perfect. Instead, investors want to know that the underlying exercises have taken place and that lessons learned from similar exercises in the past have been incorporated into current iterations.

Most company viability statements include information about a 'worst-case scenario' (or equivalent). In addition, some companies provide other scenarios that may focus on less extreme situations.

As with other aspects of the annual report, investors want information to be balanced. In other words, companies should ensure that any scenarios provided are realistic and consider both positive and negative eventualities.

"Forecasts usually tell us more of the forecaster than of the forecast" Warren Buffett

Helping investors to understand Extract
The different scenarios and situations considered, and stress tests performed, and how these tie into other areas of reporting and the company's view of the future. HSBC Holdings plc
Rolls-Royce Holdings plc
Tesco plc
Next plc

Scenario analysis versus stress tests

Whilst the definitions or interpretations of 'scenario analysis' and 'stress tests' may differ, the primary differentiating factor is the level of focus and number of variables considered. Scenario analysis usually examines how changes in a number of factors will impact a situation into the future. Stress tests usually examine the impact of a single change to one event or to a situation under extreme circumstances, and may involve analysing choices working back from that situation.

In a case study relating to stress testing and scenario analysis, Barnett Waddingham provides explanations of the terms largely consistent with those used by participants during our discussions.

Scenario selection and time horizons

We are developing our own internal capabilities to define and set parameters for bespoke scenario modelling as part of our scenario analysis framework implementation plan. Our pilot was run on a suite of specific scenarios published by the Network of Central Banks and Supervisors for Greening the Financial System ('NGFS'). The NGFS scenarios test a broad range of possible outcomes and have been created as a starting point for central banks and supervisors.

The NGFS scenarios reflect a range of potential future scenarios that encompass a complex set of social, political and economic decisions¹. They can be grouped into the following three types:

  • Orderly transition - this assumes early introduction of climate policies that gradually become more stringent. Net zero CO2 emissions will be achieved before 2070, giving a 67% chance of limiting global warming to below 2°C and leading to low physical and transition risks.
  • Disorderly transition - this assumes climate policies are not introduced until 2030. Late introduction and limited available technologies mean emissions reductions need to be sharper, which will drive increased transition risks.
  • Hot house - this assumes currently implemented policies are preserved. Emissions grow until 2080 leading to 3°C or more of global warming and subsequent severe physical risks.

We developed our scenario test over a 30-year time horizon to ensure that it reflected the long-term effects of transition and physical risks on our customers.

Use of climate stress testing and scenario analysis to answer strategic questions

Guiding questions
- How will our clients be impacted under different climate scenarios?
- How should we advise our clients to mitigate their climate risk exposure?
- How do we accurately track and monitor impact of climate risk on performance?
- What is the impact of climate risk on our business plan?
- Do we have sufficient financial resources given the potential climate scenarios?
- Does our financial resource allocation approach reflect the climate risks facing the business?
- Where are the key pockets of climate risk in the portfolio?
- Is this climate risk exposure within risk appetite?
- What is the impact of potential mitigation actions?
Embedding into core processes
Product design Strategic planning
Risk management Regulatory reporting
Capital planning Public disclosures
Client advisory and decision making
Performance metrics

HSBC Holdings plc Task Force on Climate-related Financial Disclosures Update 2020 pages 13 and 16

What is useful? HSBC provides insight into its climate-related scenarios and how these link to the company's risks and climate-related goals (communicated through the strategic questions the analysis aims to answer). A discussion of the impact on stakeholders is provided, too.

Infographic detailing key drivers of climate risk for residential real estate, use of climate stress testing, and scenario selection processes.

Rolls-Royce Holdings plc Annual Report 2020 page 53

What is useful? Rolls-Royce indicates the key areas of estimation uncertainty that it has identified and how these are incorporated into scenarios. The assumptions underpinning each of the scenarios are explained and provide enough detail to evaluate the scenarios and the company's conclusions.

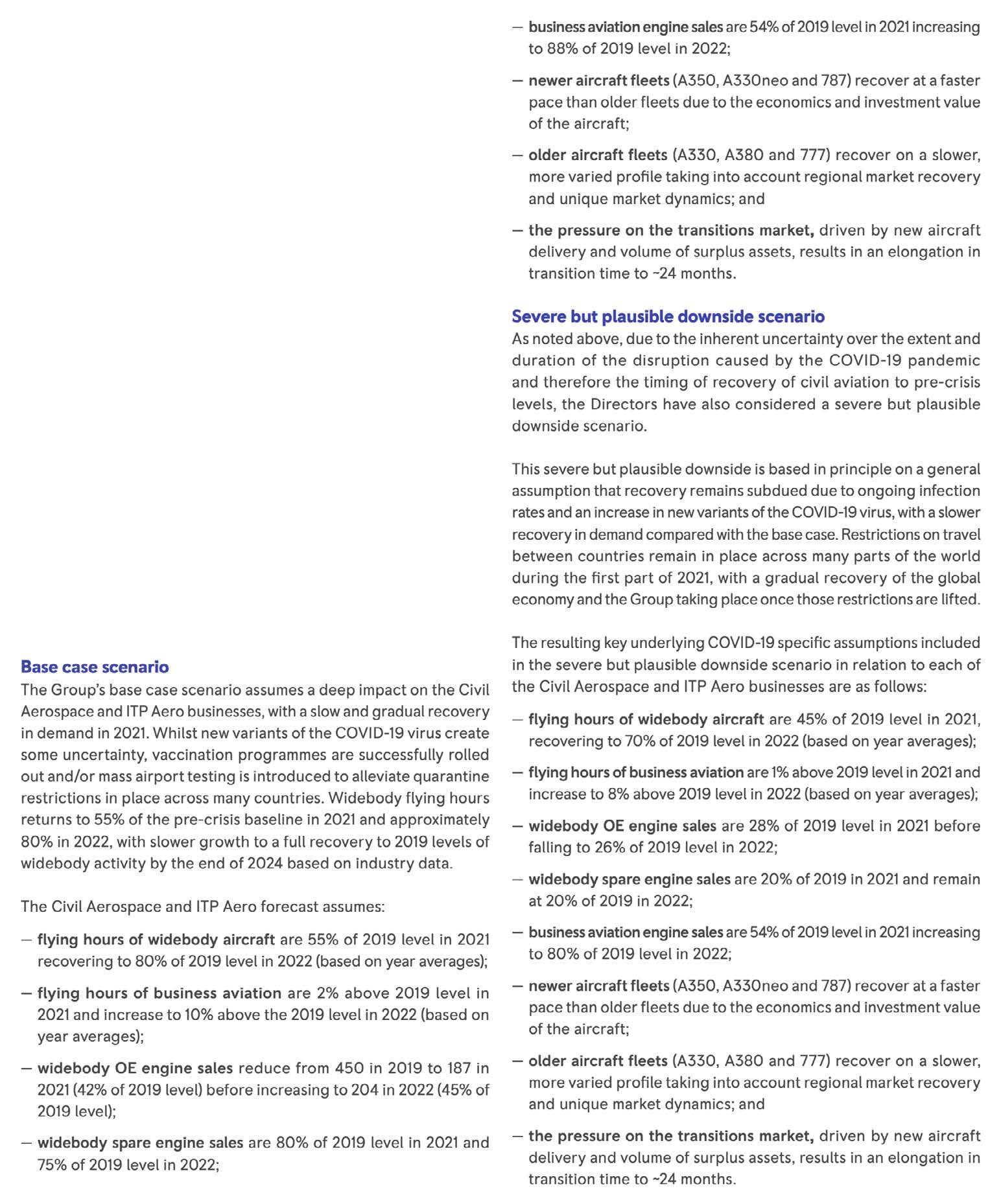

Text detailing base case and severe downside scenarios for Civil Aerospace and ITP Aero businesses, including forecasts for widebody aircraft flying hours, business aviation, and engine sales.

Tesco plc Annual Report and Financial Statements 2021 page 39

What is useful? Tesco provides a link between the principal risks reported and the scenarios used in its assessment of the company's viability.

Table detailing risk scenarios: Macroeconomic downturn, Brexit, COVID-19, Climate change, and Data security breach, along with associated risks and descriptions.

Next plc 15 year stress test

What is useful? Next provides an interactive 'stress test' in an Excel format that allows users to alter a range of assumptions and inputs and see how these impact the outcome. This tool clearly illustrates the uncertainty inherent in such exercises. Even though the model was produced before the COVID-19 pandemic it still provides insight.

REPORTS AND PRESENTATIONS

Our full financial calendar can be found by clicking here. If you would like to be notified when a new report/presentation is added to this site, please register with our Alert Service.

Table of financial reports and presentations for 2018/19, including "Annual report and accounts" (PDF) and "Fifteen year stress test model" (Excel), both dated Jan 2019. It features year-selection tabs.

15-YEAR STRESS TEST: RETAIL ANALYST VERSION

Introductory screen for the 15-Year Stress Test Retail Analyst Version, detailing conditions of use, forward-looking estimates, and options for briefing notes, disclaimer, and continuing.

Table showing Next Company Stress Test, detailing Sales Growth Inputs and Output Compound Growth Rates for segments like Next UK, Label UK, Retail, Overseas, and Group, across 1-5, 6-10, 11-15 year periods, and a 15-year total.

Top tips: Scenario analysis and stress testing

While it is impossible to predict the future, it is very important to provide insight to users of the process undertaken in conducting scenario analysis. This illustrates how management views the business in the context of the environment it currently operates in and how it anticipates this will change over time. The process also allows management to tailor responses to changes in those factors identified in the scenario analysis and other 'unexpected' factors.

In the past, the Lab has identified many 'tips' regarding scenarios and their reporting. The following are some suggestions of how scenarios can be enhanced:

  • Scenarios help management to develop an agile mind-set. The focus should be on what plausible actions can be taken in response to events and do not report actions unlikely to be taken.
  • The chosen scenarios will not always reflect what transpires but this is not the point. The purpose of scenario analysis is instead to give comfort that a range of scenarios and outcomes are being considered. Disclosures of process, inputs, assumptions, actions and responses help investors obtain comfort over scenarios.
  • All companies are affected by events or circumstances, but in different ways. Explain unique circumstances where relevant to users' understanding rather than providing generic scenarios and narrative.
  • A scenario does not stand alone, it should make sense in the context of the rest of the report and the company's specific circumstances.
  • Determining the future is not a perfect science and previous scenarios may not have been completely accurate. However, they should not be disregarded entirely as they are a vital source of information and learning. Explain how the company got from there to here and how the past shapes the future.
  • Be clear on the detail of stress tests, do not just state that they have taken place.

Appendices

Appendix 1: Regulatory glossary

The following are the main regulations and guidance that provide valuable context for this report.

Companies Act 2006 ('Companies Act')

Section 414C(2)(b) requires that the Strategic Report contains a description of the principal risks and uncertainties facing the company. This requirement applies to a wide range of companies, including UK AIM and many private companies. It sits alongside the requirement for a balanced and comprehensive analysis of the development, performance and position of the company in Section 414C(3).

The requirement to disclose a non-financial information statement was introduced as part of the changes presented by The Companies (Miscellaneous Reporting) Regulations 2018 and subsection 414CB(2) includes a requirement for a description of principal risks and, where relevant and proportionate, relationships that may have an adverse effect on these risks and how the risks are being managed.

Guidance on the Strategic Report 2018 (the Guidance)

The Guidance supports and expands on ways to approach the legislative requirements within the Strategic Report section of the Companies Act. Paragraph 7A.28 of the Guidance explains that the risks and uncertainties included in the Strategic Report should be those considered by the entity's management to be material to the development, performance, position or future prospects of the entity. They will generally be matters that the board regularly monitor and discuss because of their likelihood, the magnitude of their potential effect on the entity, or a combination of the two.

The UK Corporate Governance Code 2018 (the Code)

The Code was updated in 2018 and applies to accounting periods beginning on or after 1 January 2019. There are a number of relevant Code principles and provisions related to risk. For example, the Code reinforces the need for risk considerations to sit within the wider context of the company's business model and long-term success.

In addition, the Code sets the framework for a two-step process commonly referred to as the viability statement. Provision 31 states that:

"Taking account of the company's current position and principal risks, the board should explain in the annual report how it has assessed the prospects of the company, over what period it has done so and why it considers that period to be appropriate. The board should state whether it has a reasonable expectation that the company will be able to continue in operation and meet its liabilities as they fall due over the period of their assessment, drawing attention to any qualifications or assumptions as necessary".

The FRC also issued Guidance on Risk Management, Internal Control and Related Financial and Business Reporting in 2014. This provides further guidance on risk and viability reporting, including a section on the 'Long Term Viability Statement'.

Appendix 2: Process and participants

Participants join projects by responding to a public call or being approached by the Lab. An iterative approach is taken, with additional participants sought during the project, though it is not intended that the participants represent a statistical sample. References made to views of 'companies' and 'investors' refer to the individuals from companies and investment organisations that participated in this project. Views do not necessarily represent those of the participants' companies or organisations.

Views were received from a range of UK and international institutional investors, analysts and retail investors through a series of in-depth interviews. We also heard from a range of companies through one-to-one interviews or roundtables with other agencies.

The Lab also received a great deal of support from a wide range of organisations, advisors and others throughout this project, particularly those organisations that have been working in this area for a number of years. This assistance has been invaluable, and we thank these organisations for giving so generously of their time.

Thank you to all of the participants for contributing their time to this project.

Companies

  • 3i Group plc
  • Antofagasta plc
  • Ashmore Group plc
  • Coastline Housing Ltd
  • Croda International plc
  • Coca-Cola Europacific Partners plc
  • Coca-Cola Hellenic Bottling Company
  • First Group plc
  • Fresnillo plc
  • Hill and Smith Holdings plc
  • International Consolidated Airlines Group S.A.
  • InterContinental Hotels Group plc
  • ITV plc
  • J Sainsbury plc
  • Keller Group plc
  • Legal & General Group plc
  • MP Evans Group plc
  • NatWest Group plc
  • Northern Ireland Water Ltd
  • Polymetal International plc
  • Royal Mail Group plc

Investors and other users

  • Artemis Investment Management LLP
  • Allianz Global Investors GmbH
  • Asset Management One
  • International Ltd
  • Castlefield Investment Partners LLP
  • Evenlode Investment Management Ltd
  • Federated Hermes International
  • Representatives of the UK Shareholders' Association

We would also like to thank the following agencies for hosting company roundtables, where the Lab gathered further views:

  • Emperor
  • Falcon Windsor

Explore more work of the Lab

The Lab has published reports covering a wide range of reporting topics, including ones that are relevant to the topic of risks, uncertainties, opportunities and scenarios:

  • Risk and viability reporting (2017)
  • Business model reporting (2016)
  • Business model reporting; Risk and viability reporting – implementation study (2018)
  • COVID-19 – Going concern, risk and viability
  • COVID-19 - Going concern, risk and viability – a look forward
  • COVID-19 - Resources, action, the future
  • COVID-19 - Resources, action, the future – a look forward

The FRC does not accept any liability to any party for any loss, damage or costs howsoever arising, whether directly or indirectly, whether in contract, tort or otherwise from any action or decision taken (or not taken) as a result of any person relying on or otherwise using this document or arising from any omission from it.

© The Financial Reporting Council Limited 2021 The Financial Reporting Council Limited is a company limited by guarantee. Registered in England number 2486368. Registered Office: 8th Floor, 125 London Wall, London EC2Y 5AS

Reports and information about the Lab can be found at https://www.frc.org.uk/Lab

Follow us on Twitter @FRCnews or LinkedIn

Financial Reporting Council 8th Floor 125 London Wall London EC2Y 5AS

+44 (0)20 7492 2300 www.frc.org.uk

  1. The FRC published its statement of intent on ESG challenges in July 2021.

  2. A black swan event is one that is highly unlikely to occur but could have severe consequences if it did.

File

Name Risks, uncertainties, opportunities and scenarios
Publication date 27 September 2023
Type Report
Format PDF, 9.5 MB
